Project Walkthrough

Roof Replacement Timeline

A day-by-day guide to what actually happens during a roof replacement — from your first call through final cleanup.

If you've never had a roof replaced before, the process can feel opaque. How long will it take? Will I need to leave the house? What about my landscaping? When does materials show up?

This guide walks through a typical North Georgia roof replacement project from start to finish — both for cash-paying customers and for insurance claim projects (which take longer). It's based on hundreds of projects we've completed across Forsyth, Hall, Gwinnett, Fulton, Jackson, and Barrow counties.

Two timelines: cash vs insurance

Cash projects (you're paying out of pocket without an insurance claim) and insurance projects (carrier is paying for storm damage) follow different schedules. Most of the difference is in the front half — actual installation is similar.

Phase Cash project Insurance project
Inspection & quote 1-3 days 1-3 days
Insurance claim & adjuster N/A 2-4 weeks
Contract & deposit Same day to 1 week After claim approval
Materials delivery & scheduling 1-3 weeks 1-3 weeks
Installation 1-2 days 1-2 days
Final inspection & paperwork 1-3 days 1-3 days
Depreciation release (insurance) N/A 2-4 weeks after completion
TOTAL TIMELINE 2-4 weeks 4-10 weeks

Phase 1: Initial inspection and quote (1-3 days)

The process starts with a free inspection. We schedule typically within 24-48 hours of your call. The inspection itself takes 30-45 minutes:

You'll receive a written quote within 1-3 business days, usually with two or three options at different price points (e.g., GAF Timberline HDZ baseline, GAF Timberline UHDZ upgrade, GAF Designer line for premium homes).

Phase 2 (insurance only): claim filing and adjuster meeting (2-4 weeks)

If your project is going through insurance, this phase doesn't apply to cash customers. For storm damage:

If the scope is acceptable, we proceed to contract. If not, we submit a supplement request for missed damage — adding 1-3 weeks to the timeline.

Read more about filing an insurance claim if you're early in this process.

Phase 3: Contract signing and deposit (1 day)

Once you've decided to move forward, we sign a contract that specifies:

Standard payment structure: small deposit (10-25%) at contract signing, balance due upon completion. For insurance work, the structure is typically deposit + balance after carrier release of depreciation.

Phase 4: Materials ordering and scheduling (1-3 weeks)

Once the contract is signed:

Weather can shift the schedule. We don't tear off a roof if the forecast shows rain within the work window. If a project gets pushed by weather, we typically reschedule for the next clear day, often within a week.

Phase 5: Day before installation

The day before work starts:

Phase 6: Day 1 of installation (the loud day)

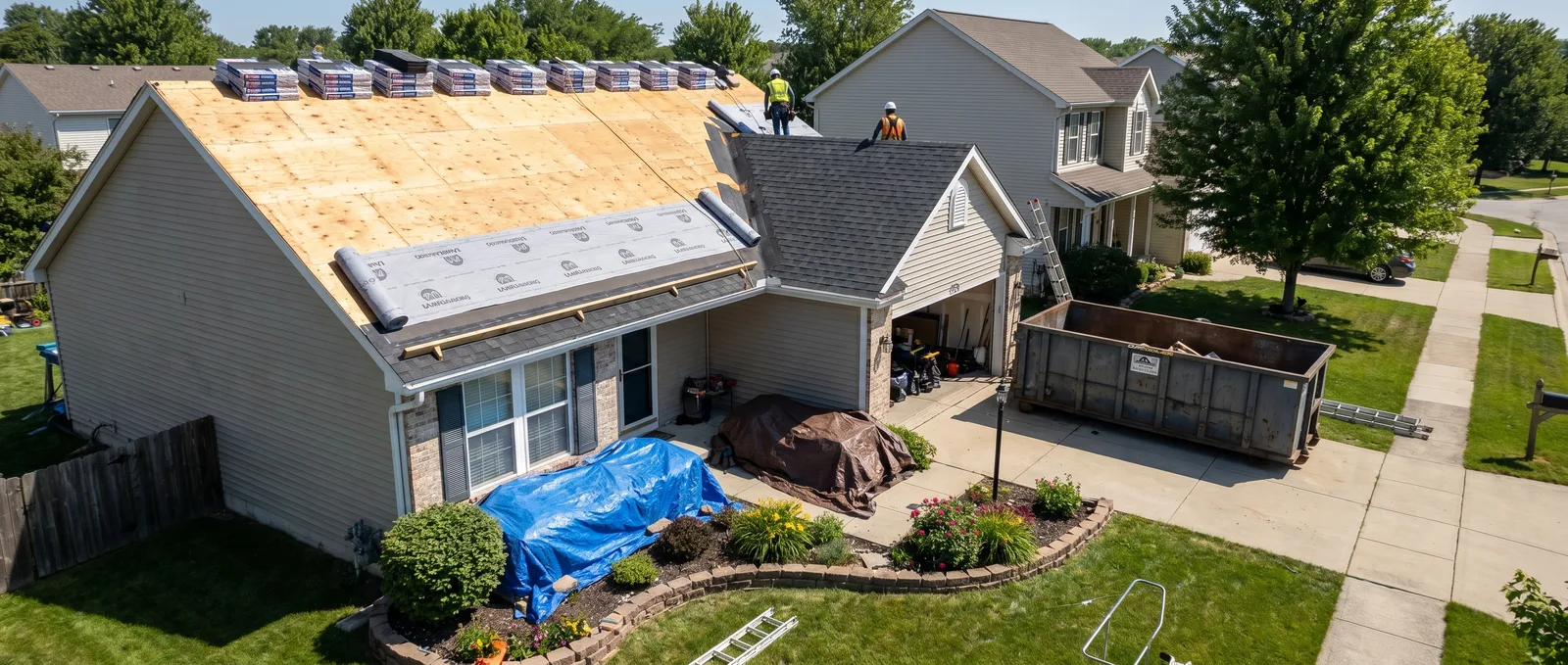

This is the messy day. Most of the disruption happens on day one:

From inside the house: expect loud impact noise from 7 AM to about 4 PM. Pets typically need to be in interior rooms, not near the affected slopes. Conversations on phone calls and video meetings are difficult during peak work — most of our customers either work elsewhere on installation day or schedule lighter work.

Phase 7: Day 2 of installation (the quiet-er day)

Day 2 is shingle installation:

For most homes (28-30 squares), the entire installation is complete by end of day 2. Larger or more complex roofs may extend into day 3.

Phase 8: Final inspection and paperwork (1-3 days)

After completion:

Phase 9 (insurance only): depreciation release

For insurance projects, the carrier releases the depreciation portion of your claim 2-4 weeks after we submit final completion paperwork. This is the "second check" on RCV policies. Once you receive it, you forward it to us for the balance of the project cost.

If you have questions about ACV vs RCV, that guide explains how the two checks work.

What can go wrong (and how we handle it)

Weather delays

Rain or storms during a tear-off can extend the project by a day or two. We tarp exposed areas and resume when weather clears. This rarely affects total project cost.

Decking damage discovered mid-project

About 30% of replacements involve some decking replacement (rotted or soft plywood). Your contract should include an allowance for X squares of decking replacement at a per-square cost. Beyond that allowance, additional decking is billed separately. We document with photos before installing new decking.

Materials backorder

Rare, but designer lines and unusual colors occasionally have 2-4 week wait times. We disclose any backorder concerns at contract signing.

Insurance supplement issues

If the adjuster scoped only partial replacement and full replacement is needed (for code or matching law reasons), we submit a supplement. The carrier typically responds within 1-2 weeks, then approves or denies. Approval extends the timeline by 2-3 weeks total; denial means we need to file a formal appeal.

What to expect afterward

The bottom line

A typical North Georgia roof replacement is a 2-4 week project end to end (cash) or 4-10 weeks (insurance), with 1-2 days of actual roof work. Plan around the loud installation days, but don't expect to need to leave your home. Communicate clearly with your contractor about scheduling, scope, and expectations — most issues during projects come from misalignment on these things rather than installation problems.

If you're planning a replacement and want a clear sense of the timeline for your specific project, give us a call. We'll walk you through the schedule from start to finish before you sign anything.

Frequently asked questions

How long does a roof replacement take from start to finish? +

From signing the contract to completed work, expect 1-4 weeks for cash projects, 4-10 weeks for insurance claim projects. The actual installation is typically 1-2 days. Most of the timeline is scheduling, materials delivery, and (for insurance work) carrier processing.

Will I need to leave my home during the replacement? +

No. Roof replacements are noisy and disruptive but homeowners stay in the house. Plan for: nail-gun noise from 7 AM until late afternoon for 1-2 days, occasional debris falling on flower beds and walkways, and a temporary staging area for materials in the driveway. We protect landscaping, but having sensitive items moved off the porch and away from windows is helpful.

Can it rain during a roof replacement? +

Generally no — we don't tear off a roof if rain is forecast within the work window. If weather changes mid-project, we tarp the exposed sections and resume when the weather clears. Underlayment provides additional protection while shingles are being installed. We've never had interior water damage from a project we managed start-to-finish.

What about my plants, lawn, and driveway? +

We protect landscaping with tarps and physical barriers, place dumpsters on plywood to prevent driveway damage, and run a magnetic sweeper across the lawn at the end of each day to pick up loose nails. Some debris is unavoidable in flower beds, and we hand-pick larger pieces, but tiny granules and roofing fragments may persist for several days afterward and wash away with the next rains.

Will I need to be home during the work? +

Not necessarily. We need someone present at the project start (to confirm scope and material delivery) and at the project end (final walkthrough). The middle days, you can come and go normally. Many of our customers work from home during projects with no significant disruption — it's loud but the work is outside.
